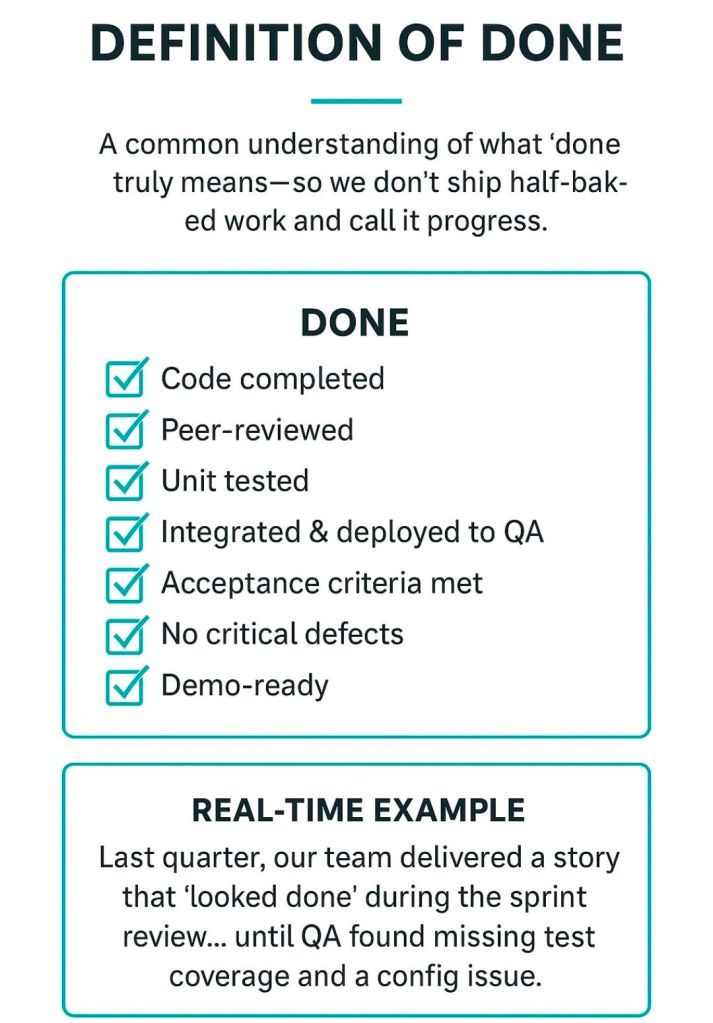

The Definition of Done (DoD) in Agile Scrum is a shared, team-wide checklist of the quality criteria every product backlog item must meet before it can be considered truly complete and releasable. It ensures consistent quality standards and prevents “almost done” work from accumulating as technical debt.
DoD vs. Acceptance Criteria
It is common to confuse the DoD with Acceptance Criteria, but they serve different purposes:
Definition of Done: Applies to all product backlog items. It dictates the technical quality standards (e.g., code reviewed, tests passed) required to be releasable.
Acceptance Criteria: Specific to an individual user story. It details the unique functional behaviors and business requirements needed to satisfy the user.
Typical DoD Checklist
While the DoD evolves as the team matures, a standard software development checklist often includes:
In Agile and Scrum frameworks, the Business Analyst (BA) bridges the gap between high-level business vision and tactical development execution. During Sprint Planning, a BA’s primary focus is to ensure that the development team has absolute requirement clarity, eliminating assumptions before a single line of code is written.
The exact focus areas of an Agile Business Analyst are divided into pre-planning readiness, active session support, and look-ahead risk management.
1. Requirements Readiness (Definition of Ready)
The primary pre-planning objective for a BA is ensuring that the top of the Product Backlog satisfies the team’s “Definition of Ready” (DoR).
INVEST Criteria: Verifying that each Product Backlog Item (PBI) is Independent, Negotiable, Valuable, Estimable, Small, and Testable.
Acceptance Criteria: Drafting robust, edge-case-tested functional parameters (often using the Given-When-Then format) to govern testing.
Business Rules & Models: Mapping complex data models, workflows, and process rules so developers have clear visuals alongside text.
2. Guarding the Business Value and Sprint Goal
While the Product Owner (PO) sets the priority, the BA confirms that the selected sprint backlog items align logically to form a cohesive target.
Sprint Goal Formulation: Supporting the PO in defining a functional, clear objective for the iteration rather than a random collection of tickets.
Value Justification: Serving as the “voice of the user,” reminding the technical team why a feature is being built and how it affects the end-user journey.
3. Technical and Functional Bridging
During the actual planning meeting, developers break down stories into sub-tasks and estimate effort. The BA provides live context.
Assumption Removal: Answering immediate clarifications regarding data constraints, legacy dependencies, or UI expectations.
Sizing Support: Assisting the team during story-point estimation by highlighting hidden functional complexities that impact effort.
Scope Trimming: Helping break down massive User Stories (Epics) into bite-sized, single-sprint tasks if an item is deemed too large.
4. Dependency and Risk Mitigation
A critical focus for the BA is ensuring the upcoming sprint does not get blocked by outside factors.
Cross-Team Alignment: Identifying if a story relies on an API or data feed managed by an external team, ensuring those pieces are unblocked.
Non-Functional Requirements (NFRs): Catching frequently missed parameters, such as specific security protocols, compliance standards, or localization requirements, before work kicks off.
Mark Whitfield’s Project Management (PM) methodology relies on over 200 editable templates tailored for both Agile Scrum and Waterfall / PRINCE2 frameworks. Developed over 24 years of IT and digital delivery, the toolkit focuses on high-level reporting, rigorous risk control, and visual tracking to align teams with corporate governance.
An example of many Plan On a Page (POAP) templates
Templates by Category and Methodology
1. Detailed Planning & Scheduling
Methodology: Mapped to the Software Development Life Cycle (SDLC) for both sequential Waterfall phases and iterative Agile sprints.
Templates:
Microsoft Project (MPP): Fully loaded schedules detailing project inception, elaboration, construction, and transition.
Excel Detailed Plans: Work Breakdown Structure (WBS) mapped to sequential and date-driven task management with built-in RAG (Red/Amber/Green) status indicators.
2. Visual Reporting & Execution (Plan on a Page)
Methodology: Focuses on structural, executive communication to prevent scope creep and keep stakeholders aligned.
Templates:
POaP (Plan on a Page): High-level visual summaries designed for client presentations and quick-glance milestone tracking in Excel and PowerPoint.
Burn-up / Burn-down Charts: Visual tracking metrics used in Agile Sprints to show progress towards delivery goals.
3. Risk & Governance Control
Methodology: Built on strict risk/action tracking and regular lessons learned to manage uncertainty throughout the project lifecycle.
Change Requests/Decisions Log: Supplementary tabs within the RAID register to strictly manage scope changes and project governance.
4. Financial Trackers
Methodology: Ensures project adherence to contracted margins, tracking both internal/external costs and resource efforts.
Templates:
Budget & Resource Trackers: Spreadsheets for forecasting versus actual expenses, variance calculations, expense reporting, and margin tracking with pivot-table readiness.
5. Team RACI & Status Reporting
Methodology: Clearly defines stakeholder roles and communication frequencies (weekly/monthly) to ensure continuous monitoring and control.
Templates:
RACI Matrix: A mapping tool defining who is Responsible, Accountable, Consulted, and Informed.
Weekly Status Reports: Word/Excel templates detailing internal and external project health, current milestones, and upcoming sprints.

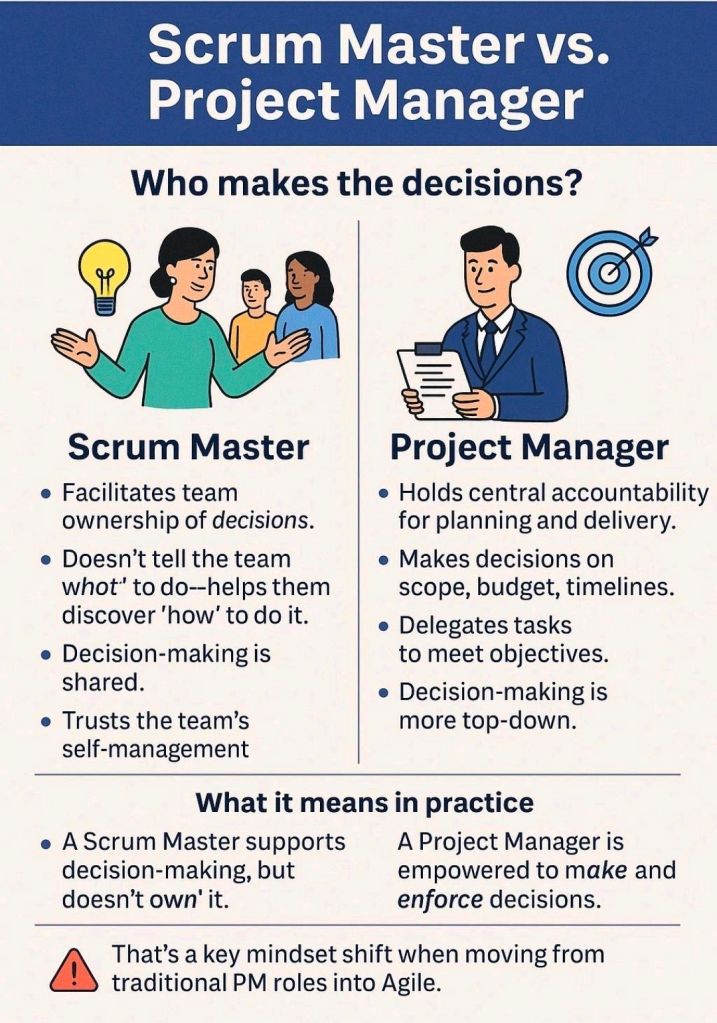

The fundamental difference in project delivery ownership is that a Project Manager (PM) owns the overall project outcomes (Scope, Schedule, Budget, Risks), whereas a Scrum Master (SM) owns the delivery process, team effectiveness, and Agile practices.
Scrum Master vs Project Manager – who owns delivery
A PM directs what needs to happen externally, while an SM coaches how the team works internally.
Scrum Master vs Project Manager
Detailed Ownership Breakdown
1. Scope, Requirements, and Product Backlog
Project Manager: Directly manages the agreed-upon project scope. They review change requests, evaluate how scope changes impact the budget, and negotiate modifications with stakeholders. They are legally or contractually accountable for delivering the specified scope.
Scrum Master: Holds no direct ownership over the product content or scope. Instead, they coach the Product Owner on how to effectively manage the Product Backlog, draft clear user stories, and refine items for upcoming sprints.
2. Schedule, Milestones, and Timeline
Project Manager: Owns the macro-level timeline. They track critical path milestones, define task dependencies across multiple teams, and are accountable to executive management if a delivery deadline is missed.
Scrum Master: Owns the micro-level iteration cadence (sprints). They do not assign tasks or dictate schedules. Instead, they facilitate Sprint Planning, ensuring the team commits to a sustainable pace of predictable delivery.
3. Budget and Financial Accountability
Project Manager: Fully owns the project’s financial performance. They forecast costs, track actual spend against the budget, manage vendor contracts, and seek approval for capital expenditures.
Scrum Master: Has zero financial accountability or budget ownership. Their focus is entirely operational—maximizing value and efficiency through team performance rather than managing corporate balance sheets.
4. Issue Resolution and Risk Management
Project Manager: Focuses on long-term, macro-level risks (e.g., market shifts, organizational changes, vendor failures). They maintain formal risk registers and coordinate executive-level mitigation plans.
Scrum Master: Focuses on immediate, tactical impediments. They own the removal of daily “blockers”—such as technical hurdles, broken tools, or communication gaps—that slow down the development team.
5. Team Governance and Task Assignment
Project Manager: Operates with a directive or orchestrating leadership style. They often assign work packages, manage resource utilization, and hold individuals accountable for specific task deadlines.
Scrum Master: Operates as a servant-leader and coach. They have no direct authority over team members and do not assign tasks. They empower the team to self-manage, collaborate, and decide collectively how to accomplish the work.
Summary of Success Metrics
The Project Manager succeeds when the project is delivered on time, within budget, and according to specifications.
The Scrum Master succeeds when the team becomes highly self-managing, continuously improves, and predictably delivers increments of high value.
In Agile projects, gap analysis shifts from a heavy upfront documentation exercise to a dynamic, continuous evaluation of the difference between your product’s current capabilities and your user’s actual needs.
Instead of building massive compliance checklists, Agile teams break gaps down into functional, team-level increments embedded directly into product development loops.
🛠️ How Gap Analysis Maps to Agile Artifacts
Agile doesn’t use a standalone “Gap Analysis Report”. Instead, gaps are converted directly into standard Agile artifacts to keep the delivery team moving:
The Epic Level (Strategic Gaps): Large operational or technical gaps (e.g., “System lacks multi-factor authentication”) are captured as Epics.
The User Story Level (Functional Gaps): Epics are sliced down into smaller, testable User Stories that represent a single increment of closing that gap (e.g., “As a user, I want to receive an SMS verification code to secure my login”).
The Backlog (Prioritisation): Identified gaps are estimated, given a business value, and ranked directly alongside feature requests in the Product Backlog.
📋 The 4-Step Agile Gap Process Breakdown
Agile teams continuously execute gap analysis iteratively through four distinct stages:
1. Define the Current State (Where We Are Now)
Action: Evaluate the existing performance or architecture using live metrics, user research, and current automated test results.
Agile Tool: Review system metrics, customer churn data, or velocity charts during Retrospectives. Avoid vague complaints; stick strictly to measurable facts.
2. Envision the Desired Future State (Where We Want to Be)
Action: Define target benchmarks or expected system behavior.
Agile Tool: Leverage the Product Vision, user personas, acceptance criteria, or your team’s Definition of Done (DoD) to serve as the baseline future state.
3. Identify and Analyze the Gap (The “Why”)
Action: Highlight the specific differences between performance and goals, then uncover the underlying reasons.
Agile Tool: Run a Five Whys session or build a Fishbone Diagram during sprint planning to see if the gap is caused by legacy code (Technology), missing skillsets (People), or inefficient workflows (Process).
4. Build the Action Plan (The Bridge)
Action: Convert the necessary fixes into work items.
Agile Tool: Map the required changes directly into the Sprint Backlog as User Stories, technical spikes (research tasks), or non-functional requirements to be delivered in upcoming iterations.
⏱️ When Gap Analysis Happens in the Agile Lifecycle
Rather than an administrative phase at the very beginning of a project, gap analysis is integrated throughout standard Agile ceremonies:
Product Discovery: High-level gap analysis ensures the initial product backlog addresses actual target user needs instead of internal assumptions.
Sprint Planning: The team evaluates the gap between the sprint goal and the current codebase to pick the right stories.
Sprint Review / Demo: Stakeholders compare the working increment against their expectations. This immediately exposes any emerging functional or alignment gaps.
Retrospectives: The team conducts an internal process gap analysis to evaluate how they collaborate, uncovering process bottlenecks or technical debt.
Gap Analysis in Agile Projects, Detailed Breakdown
In an Agile environment, a Business Analyst (BA)acts as the crucial bridge between business stakeholders and the technical team. Rather than gathering all requirements upfront, Agile BAs focus on continuous analysis, delivering value in small increments, and writing lightweight user stories that adapt as the product evolves.
Transitioning from traditional (Waterfall) analysis to an Agile framework requires a fundamental shift in how requirements are handled, documented, and delivered.
The Core Shifts in an Agile BA Role
Continuous Discovery: Instead of producing a massive Requirements Document at the start, BAs analyze and refine requirements just-in-time and just-enough to keep the development team moving.
User Stories over BRDs: Traditional Business Requirements Documents (BRDs) are replaced with collaborative user stories and acceptance criteria.
Value-Driven Prioritization: The BA continuously helps the Product Owner (or acts as the Product Owner proxy) rank the Product Backlog so that the highest-value features are built first.
Shared Understanding: The focus is on face-to-face communication, workshops, and visual modeling (like wireframes) to ensure developers fully grasp what needs to be built.
Key Responsibilities
Agile BAs operate across several domains throughout the sprint lifecycle:
Backlog Refinement: Collaborating with stakeholders to break down large, complex requirements into smaller, manageable chunks (Epics to User Stories).
Definition of Ready (DoR): Ensuring that user stories are clear, testable, and have defined acceptance criteria before they are pulled into an active sprint.
Sprint Support: Answering questions from the development team in real-time, clarifying business rules, and helping to remove blockers.
Acceptance Testing: Assisting Quality Assurance (QA) teams or business users to validate that the delivered software works as intended and solves the underlying business problem.
Agile BA versus Traditional BA
Common Frameworks for Agile BAs
Scrum: Working alongside the Scrum Master, Product Owner, and Developers in short iterations (sprints), typically lasting 2 to 4 weeks.
Kanban: Managing a continuous flow of analysis work, prioritizing items on a visual board as development capacity allows.
AgileBA: A specific certification and framework designed by the Agile Business Consortium that provides BAs with practical tools for working in Agile settings.
Recommended Resources for Skill Building
To deepen your expertise in Agile business analysis, explore these highly regarded methodologies and guides:
Use the AgileBA Certification guide to understand official best practices.
Read the IIBA Agile Extension to the BABOK Guide for authoritative frameworks.
Review Bridging the Gap for practical, real-world implementation strategies.
The fundamental difference is scale: Agile Scrum is designed for a single, autonomous team (typically 5–9 people), whereas Scaled Agile Framework (SAFe) is built for the enterprise level to coordinate dozens of teams (50+ people) working toward shared business goals.
Scrum prioritizes team flexibility and speed. Conversely, SAFe trades complete autonomy for centralized alignment, consistency, and structural predictability.
Industry Perspectives on the Trade-offs
While SAFe solves enterprise synchronization challenges, it faces regular scrutiny from product leaders who argue that its highly prescriptive nature can stifle the true spirit of agility.
A popular comment from an agile practitioner on Reddit’s Scrum Community highlights the developer sentiment regarding the process overhead:
“I’ve never seen SAFe implemented without a meeting explosion. More planning, more roles, more acronyms and way more time blocked on calendars.”
Another developer shared a similar perspective on Reddit’s ExperiencedDevs Community:
“Number of meetings have increased 4x. More time is spent for planning to build software than actually building software. Bureaucratic rituals are more important than getting things done.”
Ultimately, SAFe does not replace Scrum. Most organizations implementing SAFe still utilize standard Scrum practices at the team level, leveraging the macro framework solely to manage the dependencies that threaten to derail massive initiatives.
Choosing the Right Approach
Choose Scrum if: You have a small or mid-sized setup, your teams operate independently, you are early in your Agile journey, and your primary pain point is a need for fast market-feedback loops.
Choose SAFe if: You are coordinating 50 to 1,000+ engineers across complex legacy systems, cross-team dependencies frequently delay your releases, and you need strict regulatory compliance or top-down executive alignment.
Agile Scrum Master’s Checklist for Program Increment
An Agile Scrum Master’s checklist for a Program Increment (PI)ensures your team is aligned, dependencies are resolved, and a realistic delivery plan is established for the upcoming 8–12 weeks of work. As a facilitator and coach, you support the team across three core phases: Pre-PI Planning, During PI Planning Events, and Post-PI Execution.
Here is a comprehensive checklist structured across the lifecycle of a Program Increment.
📅 Phase 1: Pre-PI Planning Readiness
Establish Sprint Cadence: Define exact start/end dates for every sprint within the upcoming PI.
Calculate Team Capacity: Factor in vacations, public holidays, corporate events, and historic team velocity.
Refine the Backlog: Collaborate with the Product Owner to ensure top features meet the Definition of Ready (DoR).
Encourage Feature Decomposition: Guide developers to begin breaking down high-priority features into draft user stories.
Prepare Digital Tooling: Set up virtual whiteboards like Miro or MURAL, and structure project boards in systems like Jira.
Align Engineering Standards: Review architectural patterns with system architects to prevent technical blockers.
🛠️ Phase 2: During the PI Planning Event
Day 1 Breakout Management: Facilitate your team’s breakdown of features into actionable, estimated sprint user stories.
Map Dependencies: Identify files, data, or logic needed from external teams and link them on the program board.
Draft PI Objectives: Help the team write clear, outcome-oriented, and SMART goals based on their planned work.
Surface Program Risks: Collaboratively categorize all technical or resource hurdles using the ROAM framework (Resolved, Owned, Accepted, Mitigated).
Day 2 Plan Finalization: Ensure uncommitted objectives are preserved for high-risk items requiring external prerequisites.
Conduct Confidence Votes: Run an anonymous digital vote to gauge psychological safety and realistic alignment before final team commitment.
🚀 Phase 3: Post-PI & Execution Tracking
Sync the Agile Tooling: Move sticky notes and analog mappings directly into active Jira epics or tracking backlogs.
Establish Sprint Tracking: Distribute automated calendar sequences for recurring Daily Scrums, Sprint Plannings, and Sprint Reviews.
Monitor Cross-Team Risks: Attend standard Scrum of Scrums (SoS) meetings to report on blockers and coordinate incoming dependency tracks.
Protect the WIP Limits: Enforce explicitly defined work-in-progress (WIP) boundaries to prevent team burnout over mid-increment changes.
Inspect and Adapt (I&A): Facilitate the final evaluation comparing actual value delivered against initial PI targets to feed process enhancements back into the train.
Story Mapping in Agile and Scrum is a visual technique that organizes user stories along a chronological user journey. It helps teams see the big picture, avoid flat, disconnected backlogs, and collaborate on planning iterative releases that consistently deliver user value.
How a Story Map is Structured
A story map is a two-dimensional grid—often built with sticky notes on a whiteboard or via software like Miro or Visual Paradigm. It breaks work down into three levels of hierarchy:
Horizontal Axis (The Spine): Arranges the customer journey chronologically.
Activities: The broadest goals a user wants to achieve (e.g., “Checkout”).
Steps: The specific tasks required to complete the activity (e.g., “Enter Shipping Info,” “Pay”).
Vertical Axis (Details & Priority): Stacks beneath each step are the detailed user stories, epics, or features. They are organized by priority, with the most critical or highly sophisticated tasks at the top.
The Benefits of Story Mapping
Teams use this technique—popularized by Jeff Patton—to achieve several core Agile goals:
Prevents “Flat Backlog” Blindness: Gives stakeholders and developers a birds-eye view of how the entire application or feature fits together.
Defines the MVP: Allows teams to draw horizontal “release lines” across the map. The items sitting above this line form the barebones “walking skeleton” or Minimum Viable Product (MVP).
Aids Sprint Planning: Helps the Product Owner pull well-sequenced, context-aware stories directly into sprint backlogs.
Fosters Collaboration: Moves the team away from siloed requirement docs and toward collaborative conversations around actual user behavior.
Typical Agile Scrum Master interview questions evaluate your understanding of the Scrum Framework (the 3-5-3 structure), your ability to facilitate continuous improvement, and your soft skills in conflict resolution and servant leadership.
The questions generally fall into four core categories:
1. Scrum Fundamentals & Frameworks

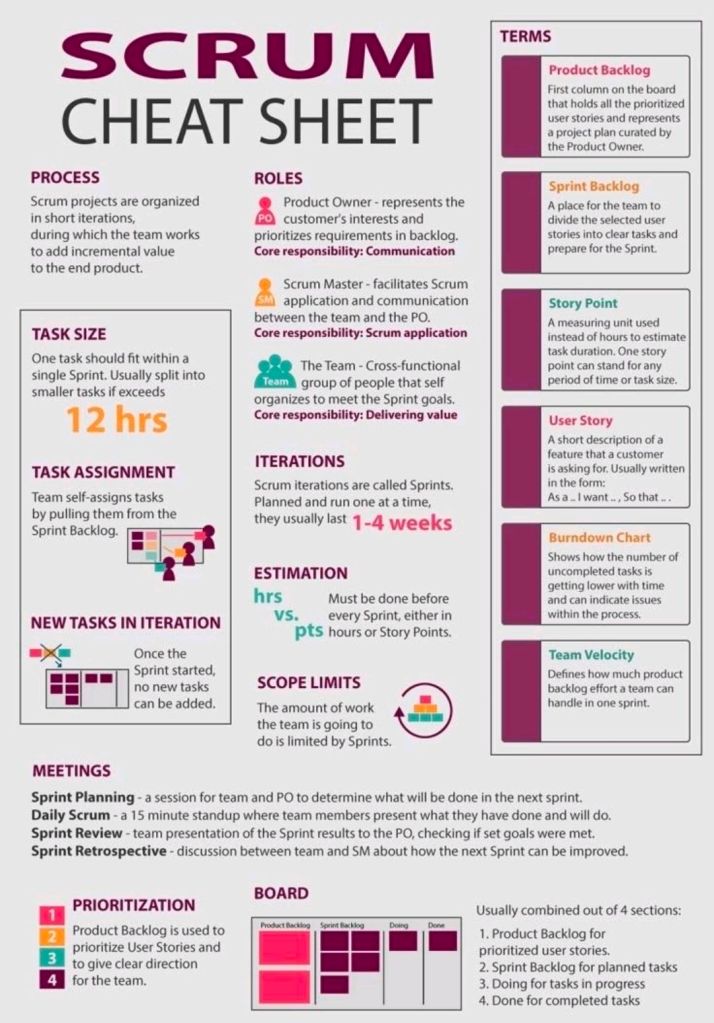

These questions test your technical knowledge of Scrum and how it compares to other frameworks.
Explain Scrum vs. Agile: Agile is the overarching mindset and set of principles; Scrum is a specific, lightweight framework for implementing Agile.
The 3-5-3 structure: What are the three roles (Product Owner, Scrum Master, Developers), five events (Sprint, Sprint Planning, Daily Scrum, Sprint Review, Sprint Retrospective), and three artifacts (Product Backlog, Sprint Backlog, Increment)?
Scaling Agile: What experience do you have scaling Agile (e.g., SAFe, Scrum of Scrums, Nexus) if the organization is large?
2. Facilitation & Coaching
Interviewers want to see how you run events, coach Product Owners, and improve team delivery.
Daily Scrum: What is your approach to running the Daily Scrum, and how do you prevent it from becoming just a status update?
Retrospectives: What specific techniques or games do you use to keep retrospectives fresh and actionable?
Definition of Done (DoD): How do you help a team create and adhere to a clear Definition of Done?
Metrics: How do you track a team’s effectiveness (e.g., velocity, sprint goal success, cycle time, burndown charts)?
3. Behavioral & Situational Scenarios
These “tell me about a time when…” questions assess your real-world experience.
Team Conflict: Can you describe a time when you had to resolve a conflict between team members or between a developer and the Product Owner?
Resistant Teams: What would you do if a team member or stakeholder doesn’t see the value in Scrum ceremonies and refuses to participate?
Management Intervention: How do you handle managers or executives who try to bypass the Scrum process or assign work directly to the developers?
Scope Creep: How do you handle sudden mid-sprint requirement changes or scope creep?
4. Self-Awareness & Servant Leadership
Hiring managers ask these to test your humility and growth mindset.
Your Greatest Failure: Can you share a time you failed as a Scrum Master, and what you learned from the experience?
Protecting the Team: How do you say “no” to leadership or protect the team from external noise while still serving the broader organization?
__________
More Agile Scrum Questions with Example Answers:
Mastering a Scrum Master interview involves demonstrating a deep understanding of servant leadership, the Agile mindset, and hands-on experience navigating team dynamics. Below are the most common interview questions, summarized with strategic, industry-recommended answers to help you stand out.
Core Scrum Framework & Mechanics
Question 1: Explain the 3-5-3 structure of Scrum.
What they’re looking for: A solid foundation in Scrum basics.
Recommended Answer: “Scrum is governed by a ‘3-5-3’ rule: 3 roles (Product Owner, Scrum Master, Developers), 5 events (Sprint, Sprint Planning, Daily Scrum, Sprint Review, Sprint Retrospective), and 3 artifacts (Product Backlog, Sprint Backlog, Increment).”
Question 2: What is the difference between a Product Backlog and a Sprint Backlog?
What they’re looking for: Understanding of backlog management and scope.
Recommended Answer: “The Product Backlog is a continuously evolving, prioritized list of everything needed for the product, owned by the Product Owner. The Sprint Backlog is a subset of the Product Backlog—it’s the specific forecast of items the team commits to delivering during the current sprint.”
Behavioral & Situational Questions
Question 3: How do you handle conflict within the Scrum team?
What they’re looking for: Your facilitation and conflict-resolution skills, avoiding direct intervention where the team can self-manage.
Recommended Answer: “I avoid playing the role of a micromanager. Instead, I facilitate open dialogue and encourage the team to address the conflict directly using the Scrum values of openness and respect. My goal is to guide them to find a mutually agreeable solution while fostering an environment of psychological safety.”
Question 4: What do you do if a team member refuses to adopt Scrum practices?
What they’re looking for: Change management skills and patience.
Recommended Answer: “I first try to understand the root cause of their resistance, as it usually stems from a lack of understanding or fear of change. I would have a private one-on-one conversation to address their concerns. I might pair them with an experienced Agile advocate or use team-building exercises to demonstrate the value of Scrum in a low-pressure way.”
Leadership & Stakeholder Management
Question 5: Tell me about a time you had to challenge leadership or management.
What they’re looking for: The courage to protect the team’s focus and uphold Scrum principles.
Recommended Answer: “I once had a stakeholder attempt to bypass the Product Owner and directly assign high-priority tasks to Developers mid-sprint. I respectfully but firmly challenged this by explaining how breaking the Sprint Goal jeopardizes the team’s focus and the project’s overall velocity. I then helped the stakeholder work with the Product Owner to place the new task in the Product Backlog for the next sprint planning.”

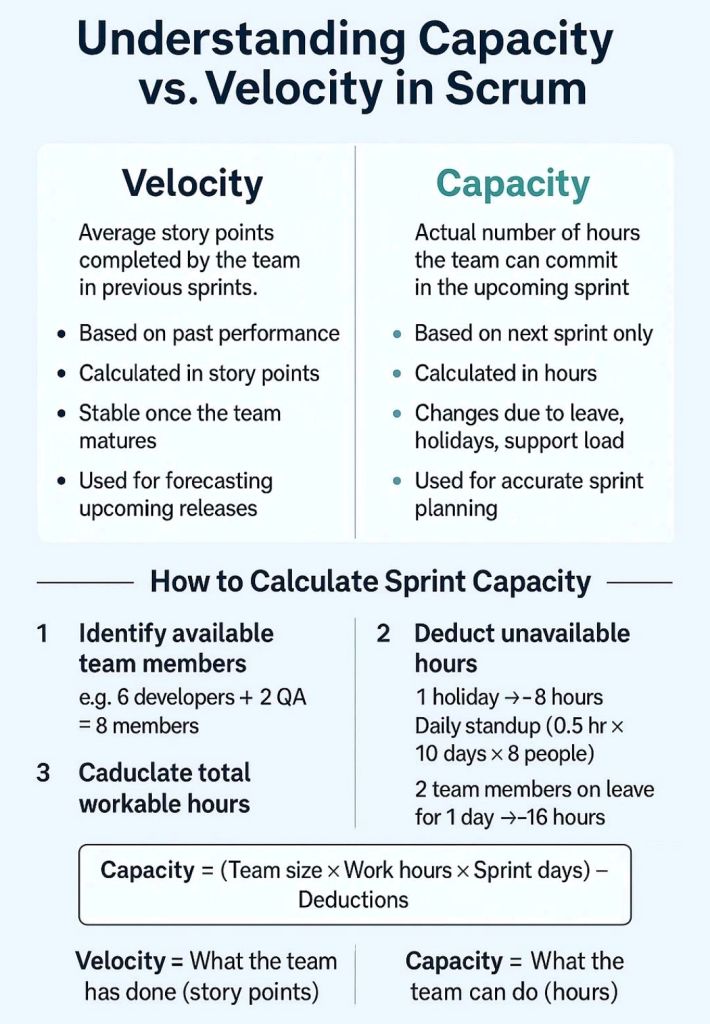

Question 6: How do you measure if your team is truly Agile?
What they’re looking for: Focus on delivering value over measuring arbitrary metrics like velocity.
Recommended Answer: “Velocity is for planning, not for measuring success. I look at outcome-based metrics, such as Sprint Goal success rates, customer satisfaction scores, time-to-market, and the quality of increments. The ultimate measure is whether we are continuously delivering iterative business value to our end users.”
SAFe (Scaled Agile Framework) events are structured, time-boxed ceremonies designed to drive synchronization, alignment, and continuous improvement across different levels of an enterprise.
These events are primarily categorized into Team-level events (which mirror standard Scrum practices) and Agile Release Train (ART) level events (which orchestrate multiple teams working toward a shared goal).
The core events within Essential SAFe are broken down below by organizational layer.
👥 Agile Team-Level Events
These recurrent ceremonies occur inside a short timebox called an Iteration (typically lasting 2 weeks) and focus on local execution.
Iteration Planning: Teams refine the iteration plan, select backlog stories, and commit to a set of Iteration Goals.
Team Sync (Daily Stand-up): A brief, daily 15-minute meeting where team members align on progress, discuss daily goals, and highlight impediments.
Iteration Review: A cadence-based showcase at the end of the iteration where teams demo working software to gather immediate feedback.
Iteration Retrospective: Held at the end of each iteration to reflect on the process, team dynamics, and behaviors to drive relentless improvement.
Backlog Refinement: A weekly meeting where the Product Owner and team flesh out, estimate, and prep user stories for upcoming iterations.
🚊 Agile Release Train (ART) Level Events
These higher-level events drive the Planning Interval (PI), an 8 to 12-week timebox where an entire “train” of 5–12 teams delivers cross-functional value.
PI Planning: The multi-day flagship event of SAFe where all teams, stakeholders, and leaders align on a shared business vision, map dependencies, and commit to PI objectives.
System Demo: A regular event occurring every iteration where the integrated functionality built by the entire ART is demonstrated to stakeholders for feedback.
Coach Sync (formerly Scrum of Scrums): Facilitated by the Release Train Engineer (RTE), Scrum Masters meet to resolve cross-team dependencies, risks, and progress hurdles.
PO Sync: Product Owners and Product Management meet to track milestone progress, manage scope adjustments, and ensure the train remains aligned with business goals.
ART Sync: A combined session of Coach Sync and PO Sync used to streamline communication regarding execution and deployment.
Inspect & Adapt (I&A): A major event held at the end of the PI consisting of a system demo, quantitative measurements, and a problem-solving workshop to implement systemic backlog improvements.
Summary of Differences
For a quick comparison, you can look at how responsibilities scale across the framework:
SAFe (Scaled Agile Framework) events are structured, time-boxed ceremonies designed to drive synchronization, alignment, and continuous improvement across different levels of an enterprise
Scrum and Kanban are both popular Agile project management frameworks, but Scrum relies on rigid, time-boxed cycles with explicit roles, while Kanban focuses on continuous workflow and limiting work-in-progress to resolve bottlenecks.
Core Mechanics of Scrum
Time-Boxed Sprints: Work is divided into locked iterations where the team commits to a specific batch of deliverables.
Strict Ceremonies: Requires mandatory structural events including Sprint Planning, Daily Scrums, Sprint Reviews, and Retrospectives.
Clear Accountabilities: Relies on a Product Owner to dictate priorities, and a Scrum Master to eliminate work blockers.
Core Mechanics of Kanban
WIP Limits: Explicitly caps the maximum number of active items allowed in any single workflow column to prevent overloading.
Continuous Delivery: Tasks flow from the backlog to “Done” independently as resources allow, rather than in batched releases.
Evolutionary Change: Fits seamlessly over existing operational hierarchies without requiring an organizational overhaul.
How to Choose the Right Framework
Choose Scrum if:
You are building a complex product requiring highly disciplined planning cycles.
The project requires substantial stakeholder engagement and frequent product reviews.
Your team prefers structured routine, cross-functional collaboration, and highly concrete targets.
Choose Kanban if:
Your workflow is dictated by inbound, unpredictable operational tasks (like IT support or bug tracking).
You want a visual aid to reveal pipeline bottlenecks without altering current team roles.
Note: Many organizations merge these models into a hybrid approach known as Scrumban, leveraging Scrum’s regular event cadences alongside Kanban’s visual WIP flexibility.
Agile estimation techniques use relative sizing rather than exact time tracking to gauge the effort, complexity, and risk of completing tasks. These collaborative methods help Scrum teams maintain predictable delivery and realistic workloads without relying on rigid, top-down predictions.
Common Agile estimation techniques include:
1. Planning Poker
How it works: Team members use a deck of cards with values from the modified Fibonacci sequence (0, 1, 2, 3, 5, 8, 13, 21, etc.). The Product Owner presents a user story, the team discusses it, and each member privately selects a card representing their effort estimate.
When to use it: Ideal for detailed sprint planning and backlog refinement, especially when you need to encourage team collaboration and reach a consensus.
2. T-Shirt Sizing
How it works: Tasks are assigned sizes (XS, S, M, L, XL) based on high-level complexity rather than precise points.
When to use it: Excellent for rapid, broad-brush estimation during initial release planning or when mapping out large Epics that aren’t yet refined into granular user stories.
3. Affinity Estimation
How it works: The team collaboratively groups user stories on a wall or digital board into columns representing different sizes. Every team member can move a story if they disagree with its current size, creating a consensus through comparative grouping.
When to use it: Best suited for large product backlogs where many items need to be sized quickly in a single session.
4. Dot Voting
How it works: Team members receive a limited number of physical or digital “dots” to place on user stories they believe carry the highest complexity or effort, prioritizing stories based on the concentration of votes.
When to use it: Helpful for quick prioritization and establishing a baseline for relative difficulty among a large list of tasks.
5. The Bucket System
How it works: Similar to Affinity Estimation, various “buckets” (numbered with Fibonacci sequences) are laid out. Stories are placed in the buckets, which helps the team rapidly categorize relative effort.
When to use it: Great for medium-to-large backlogs requiring faster execution than traditional Planning Poker without sacrificing sizing accuracy.
